Optimizing construction project outcomes through BIM and MEP system integration

Research Article
Open access

Optimizing construction project outcomes through BIM and MEP system integration

Shujie Chen 1 , Chenjie Zhu 2 , Yutao Shang 3*
  • 1 East China University of Science and Technology
  • 2 Shanghai Maritime University
  • 3 Hunan City University
  • *corresponding author 2482516799@qq.com
ACE Vol.66
ISSN (Print): 2755-273X
ISSN (Online): 2755-2721
ISBN (Print): 978-1-83558-443-9
ISBN (Online): 978-1-83558-444-6

Abstract

The integration of Building Information Modeling (BIM) with Mechanical, Electrical, and Plumbing (MEP) systems represents a transformative approach to improving efficiency, coordination, and cost-effectiveness in construction projects. This paper explores a comprehensive methodology for BIM and MEP integration, encompassing framework development, data management, and collaboration mechanisms. It highlights the significant benefits such as enhanced project coordination, improved efficiency, and cost reduction while addressing key challenges including technical barriers, cultural and organizational changes, and data security concerns. Solutions such as the development of interoperability standards, middleware technologies, robust data management protocols, and collaborative platforms are discussed. The study underscores the necessity of a multifaceted strategy involving training, change management, and leadership commitment to drive successful implementation. Through detailed analysis and discussion, this paper demonstrates how BIM and MEP integration can lead to more streamlined, cost-effective, and high-quality construction projects.

Keywords:

Building Information Modeling, MEP Integration, Construction Management, Project Coordination, Data Management

Chen,S.;Zhu,C.;Shang,Y. (2024). Optimizing construction project outcomes through BIM and MEP system integration. Applied and Computational Engineering,66,204-210.
Export citation

1. Introduction

The construction industry is at a pivotal juncture, with technological advancements paving the way for more sophisticated and integrated project management approaches. Among these advancements, Building Information Modeling (BIM) and Mechanical, Electrical, and Plumbing (MEP) integration stands out as a key driver of change, offering new dimensions of efficiency and collaboration. BIM, a digital representation of physical and functional characteristics, facilitates a shared knowledge resource for information about a facility, forming a reliable basis for decisions throughout its lifecycle. The integration with MEP systems further enhances this model by incorporating detailed designs and specifications, which are crucial for the operational success of any construction project. This paper aims to dissect the methodology behind successful BIM and MEP integration, evaluating the benefits and challenges inherent in this process. It posits that through careful planning, robust data management, and the fostering of a collaborative project culture, the construction industry can overcome obstacles to integration [1]. Such integration not only streamlines project workflows but also leads to significant cost savings, improved project coordination, and ultimately, the delivery of high-quality construction projects. Over the course of this investigation, we will explore the framework development necessary for integration, delve into the intricacies of effective data management, and highlight the critical role of collaboration mechanisms in achieving project success. Through this comprehensive examination, the paper seeks to provide valuable insights into optimizing construction outcomes through the integration of BIM and MEP systems, highlighting the potential for this approach to redefine project management practices in the construction industry.

2. Methodology of BIM and MEP Integration

2.1. Framework Development

The integration of Building Information Modeling (BIM) and Mechanical, Electrical, and Plumbing (MEP) systems commences with the establishment of a multifaceted framework designed to delineate the interaction between BIM tools and MEP design elements comprehensively. This framework is not merely a procedural guideline; it embodies a dynamic, interactive blueprint that facilitates the seamless interoperability of architectural, structural, and MEP design components within a unified modeling environment. To construct such a framework, an extensive analysis of the project’s scope, including the complexity of MEP systems, the scale of the construction, and specific stakeholder requirements, is imperative [2]. This development process involves the identification and integration of standards and protocols, such as the Industry Foundation Classes (IFC) and the BuildingSMART Data Dictionary, which ensure that the BIM model adheres to universally recognized data formats and terminologies, as shown in Figure 1.

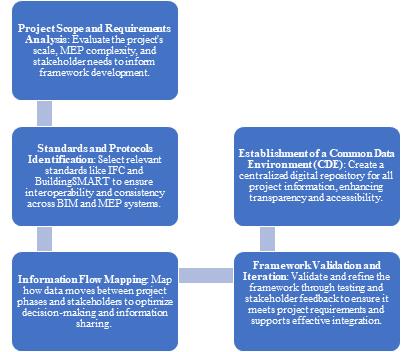

fig1

Figure 1. Development Process for BIM and MEP Integration Framework

Furthermore, the framework incorporates a detailed mapping of information flows, delineating how data moves between different project phases and stakeholders, thereby optimizing decision-making processes and enhancing project outcomes. An integral part of this framework is the establishment of a common data environment (CDE), a centralized digital repository where all project information is stored, managed, and accessed by authorized personnel. This approach not only enhances transparency and accountability but also facilitates the real-time update and retrieval of information, ensuring that all stakeholders are working with the most current data.

2.2. Data Management

At the core of BIM and MEP integration lies robust data management, critical for maintaining the integrity and utility of the BIM model throughout the project lifecycle. Effective data management within the BIM environment involves the implementation of rigorous protocols for data entry, ensuring consistency and accuracy in the representation of MEP designs. This includes the development of standardized templates and libraries for MEP components, which provide a consistent basis for modeling and reduce the potential for errors during data entry. Moreover, data storage and retrieval protocols are essential for managing the vast amounts of information generated during the design and construction processes. This involves the use of advanced database systems capable of handling complex queries and facilitating efficient data retrieval. The implementation of version control mechanisms is crucial in this context, enabling the tracking of changes over time and ensuring that stakeholders have access to the correct version of the model. The management of data within the BIM environment also extends to the integration of MEP-specific information, such as performance specifications, installation details, and maintenance requirements [3]. This detailed information enriches the BIM model, transforming it into a comprehensive resource for all phases of the project, from design through to facility management. To achieve this level of detail, close collaboration between MEP professionals and BIM specialists is required, leveraging their combined expertise to ensure that the BIM model accurately reflects the complexity and nuances of MEP systems. Table 1 summarizes the key components and practices essential for effective data management in BIM and MEP integration.

Table 1. Key Aspects of Data Management in BIM and MEP Integration

Aspect

Description

Sample Data

Data Entry Protocols

Rigorous protocols for entering data into the BIM environment to ensure consistency and accuracy in MEP design representation.

Template forms, standardized guidelines

Standardized Templates & Libraries

Development of standardized templates and libraries for MEP components to provide consistency and reduce errors in modeling.

HVAC template, Electrical library

Data Storage & Retrieval Protocols

Protocols for managing vast amounts of information generated during design and construction, using advanced database systems.

SQL database, Cloud storage

Version Control Mechanisms

Implementation of mechanisms to track changes over time, ensuring stakeholders access the correct version of the BIM model.

Git version control, Change log

Integration of MEP Information

Inclusion of MEP-specific information such as performance specs, installation details, and maintenance requirements in the BIM model.

Equipment specs, Installation manuals

Collaboration

Close collaboration between MEP professionals and BIM specialists to accurately reflect the complexity of MEP systems in the model.

Regular meetings, Shared documentation

3. Benefits of Integration

3.1. Enhanced Project Coordination

Integrating Building Information Modeling (BIM) with Mechanical, Electrical, and Plumbing (MEP) systems fundamentally transforms project coordination, facilitating a multidisciplinary approach to design and construction management. In traditional project workflows, coordination between different teams often occurs in silos, leading to fragmented communication and disjointed decision-making processes. BIM-MEP integration, however, enables a unified platform where all project data and design elements are centralized, allowing for real-time collaboration and data exchange among architects, engineers, and construction professionals. This holistic approach not only streamlines communication but also enables the early identification and resolution of design conflicts. For instance, through clash detection tools inherent in BIM software, overlapping elements between structural components and MEP systems can be identified before physical construction begins, preventing costly and time-consuming modifications on-site [4]. Moreover, the dynamic nature of BIM allows for iterative changes to be made across all models simultaneously, ensuring that all stakeholders have access to the most current information. This level of coordination significantly enhances the ability to manage complex projects, ensuring that they are completed within the prescribed timelines and budgets.

3.2. Improved Efficiency

The shared information environment fostered by the integration of BIM and MEP systems significantly enhances the efficiency of project management processes. By centralizing project data, teams can access and modify designs in a collaborative manner, drastically reducing the time and resources traditionally required for design revisions and updates. The efficiency gains are particularly notable in the context of MEP system design, which is inherently complex and requires precise coordination with the architectural and structural components of a project. BIM facilitates the automatic generation of detailed digital models that can simulate the real-world performance of MEP systems, allowing for the optimization of designs in the early stages of a project [5]. This capability to test and refine systems virtually eliminates the need for physical prototypes and reduces the likelihood of design errors, thereby minimizing the need for costly redesign work. Furthermore, the use of BIM enhances the ability to plan and sequence construction activities, enabling more efficient resource allocation and scheduling. For example, just-in-time delivery schedules for materials can be optimized, and potential bottlenecks in the construction process can be identified and mitigated in advance. These efficiencies contribute to shorter project timelines and reduced labor and material costs [6].

3.3. Cost Reduction

The early detection of potential issues through BIM and MEP integration is instrumental in driving significant cost savings in construction projects. By leveraging the comprehensive visualization and simulation capabilities of BIM, project teams can anticipate and address potential design and construction challenges before they manifest on the job site. This preemptive problem-solving approach eliminates the need for rework, which is a common source of cost overruns in construction projects. For example, BIM’s clash detection functionality allows for the identification of spatial conflicts between MEP systems and structural elements, enabling resolution before construction begins. Additionally, the detailed modeling of MEP systems within the BIM environment facilitates more accurate cost estimation and budgeting. The ability to extract precise quantities of materials from the model reduces the likelihood of underestimating or overestimating costs, ensuring that budget allocations are more accurate and controlled. Furthermore, BIM and MEP integration enhances the potential for modular and prefabricated construction approaches, which have been shown to reduce waste and increase efficiency on construction sites. By designing MEP components to be manufactured off-site and assembled on-site, projects can achieve faster completion times and reduced labor costs. Collectively, these aspects of BIM-MEP integration play a pivotal role in minimizing financial risks and enhancing the overall economic sustainability of construction projects [7]. Table 2 outlines cost-saving measures achieved through BIM and MEP integration in a construction project.

Table 2. Estimated Cost and Time Savings Achieved Through BIM and MEP Integration in Construction Projects

Cost Saving Measure

Description

Estimated Cost Savings

Estimated Time Savings

Clash Detection and Resolution

Early identification and resolution of spatial conflicts between MEP systems and structural elements using BIM.

$100,000

2 weeks

Accurate Material Quantification

Using BIM for detailed modeling and precise material quantification to avoid under/overestimation.

$50,000

N/A

Reduced Rework

Preemptive problem-solving to eliminate the need for rework due to design and construction challenges.

$150,000

1 month

Modular and Prefabricated Construction

Designing MEP components for off-site manufacturing and on-site assembly to reduce waste and increase efficiency.

$75,000

3 weeks

4. Challenges and Solutions

4.1. Challenges and Solutions

One of the primary technical barriers in the integration of BIM with MEP systems is the lack of standardization across different software platforms. This issue arises due to the diverse range of software tools used by various stakeholders in a construction project, each with its unique data formats and protocols. The disparity in software ecosystems leads to challenges in achieving seamless interoperability, crucial for effective data exchange and collaboration. To address this challenge, the development of interoperability standards is paramount. These standards would provide a unified framework for data representation and exchange, enabling different systems to communicate and understand each other’s data without the need for extensive customization. Moreover, the utilization of middleware technologies presents a viable solution to facilitate data exchange between disparate systems. Middleware acts as a bridge, allowing different software applications to interact by converting data into a common format and transmitting it across platforms [8]. This approach not only enhances interoperability but also streamlines the workflow, ensuring that updates in the MEP design are automatically reflected in the BIM model, thus maintaining consistency and accuracy throughout the project lifecycle. Implementing such solutions requires a concerted effort from industry stakeholders, including software developers, standards organizations, and construction firms, to collaborate on the development of universal standards and the adoption of middleware solutions. Furthermore, investment in research and development is critical to advance middleware technologies and ensure they are scalable, efficient, and capable of handling the complexities of BIM and MEP integration.

4.2. Cultural and Organizational Changes

Integrating BIM with MEP systems necessitates a shift towards a more collaborative and integrated project delivery approach, challenging traditional siloed work practices. This cultural and organizational change demands a comprehensive strategy, encompassing training, change management initiatives, and leadership commitment. Training programs are essential to equip project teams with the necessary skills and knowledge to effectively use integrated BIM and MEP processes. These programs should cover not only technical aspects but also emphasize the importance of collaboration, communication, and the benefits of an integrated approach to project delivery. Change management initiatives play a crucial role in facilitating this transition [9]. These initiatives should focus on addressing resistance to change by highlighting the tangible benefits of BIM and MEP integration, such as improved efficiency, reduced rework, and enhanced project outcomes. Moreover, change management strategies should include mechanisms for feedback and adaptation, allowing the organization to continuously refine and improve its integration processes based on real-world experiences. Leadership commitment is the linchpin in driving cultural and organizational change. Leaders must champion the integration of BIM and MEP, setting clear expectations and providing the necessary resources and support to achieve successful implementation. This includes fostering an environment that encourages innovation, collaboration, and open communication across all levels of the organization [10].

4.3. Data Security and Privacy

The integration of BIM with MEP systems introduces complexities in managing the security and privacy of project data. Given the collaborative nature of BIM, project data is shared among multiple stakeholders, increasing the risk of unauthorized access and data breaches. To mitigate these risks, the implementation of robust data encryption and access control measures is imperative. Data encryption ensures that project data is encrypted both at rest and in transit, making it unintelligible to unauthorized users. This is particularly important for sensitive information, such as proprietary design details and personal data of project participants. Access control measures are critical in defining who has access to what data and under what circumstances. This involves the establishment of user roles and permissions, ensuring that project team members can access only the data necessary for their specific tasks.

5. Conclusion

The integration of Building Information Modeling (BIM) with Mechanical, Electrical, and Plumbing (MEP) systems is a cornerstone for the evolution of construction project management towards greater efficiency, accuracy, and collaboration. This paper has outlined a systematic methodology for achieving successful integration, emphasizing the importance of a well-defined framework, effective data management, and robust collaboration mechanisms. Despite facing challenges such as technical barriers, the need for cultural and organizational change, and data security concerns, the construction industry stands to gain significantly from embracing BIM and MEP integration. Solutions such as interoperability standards, middleware technologies, and collaborative platforms, along with a commitment to training and change management, can facilitate the seamless integration of these systems. Ultimately, this paper demonstrates that through strategic planning and a commitment to innovation, the construction industry can leverage BIM and MEP integration to not only enhance project outcomes but also to drive the future of construction towards a more integrated, efficient, and sustainable approach. The journey towards full integration may be complex, but the benefits—a reduction in costs, improved project coordination, and the delivery of higher quality projects—make it a worthwhile endeavor for the construction sector.


References

[1]. Hall, Andrew Thomas, et al. “Multi-criteria analysis of barriers to building information modeling (BIM) adoption for SMEs in New Zealand construction industry.” Engineering, Construction and Architectural Management 30.9 (2023): 3798-3816.

[2]. Babalola, Ayotunde, et al. “A bibliometric review of advances in building information modeling (BIM) research.” Journal of Engineering, Design and Technology 21.3 (2023): 690-710.

[3]. Biljecki, Filip, Yoong Shin Chow, and Kay Lee. “Quality of crowdsourced geospatial building information: A global assessment of OpenStreetMap attributes.” Building and Environment 237 (2023): 110295.

[4]. Hagedorn, Philipp, et al. “BIM-enabled infrastructure asset management using information containers and semantic web.” Journal of Computing in Civil Engineering 37.1 (2023): 04022041.

[5]. Kuhn T 1998 Density matrix theory of coherent ultrafast dynamics Theory of Transport Properties of Semiconductor Nanostructures (Electronic Materials vol 4) ed E Schöll (London: Chapman and Hall) chapter 6 pp 173–214

[6]. Börzel, Tanja A., et al. “Contesting Europe: Eurosceptic dissent and integration polarization in the European parliament.” JCMS: Journal of Common Market Studies 61.4 (2023): 1100-1118.

[7]. Lowe, Nichola, et al. “Centering work: Integration and diffusion of workforce development within the US manufacturing extension network.” Economic Development Quarterly 37.4 (2023): 375-388.

[8]. Asci, Francesco, et al. “Pain-motor integration in chronic pain: A neurophysiological study.” Clinical Neurophysiology 154 (2023): 107-115.

[9]. Almashhadani, Mohammed, Hasan Ahmed Almashhadani, and H. A. Almashhadani. “The Impact of Education on Construction Management: A Comprehensive Review.” International Journal of Business and Management Invention 12.6 (2023): 284-290.

[10]. Likita, Ayuba Jerry, et al. “Lean and BIM integration benefits construction management practices in New Zealand.” Construction Innovation 24.1 (2024): 106-133.


Cite this article

Chen,S.;Zhu,C.;Shang,Y. (2024). Optimizing construction project outcomes through BIM and MEP system integration. Applied and Computational Engineering,66,204-210.

Data availability

The datasets used and/or analyzed during the current study will be available from the authors upon reasonable request.

Disclaimer/Publisher's Note

The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of EWA Publishing and/or the editor(s). EWA Publishing and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

About volume

Volume title: Proceedings of the 2nd International Conference on Functional Materials and Civil Engineering

ISBN:978-1-83558-443-9(Print) / 978-1-83558-444-6(Online)
Editor:Ömer Burak İSTANBULLU
Conference website: https://www.conffmce.org/
Conference date: 23 August 2024
Series: Applied and Computational Engineering
Volume number: Vol.66
ISSN:2755-2721(Print) / 2755-273X(Online)

© 2024 by the author(s). Licensee EWA Publishing, Oxford, UK. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license. Authors who publish this series agree to the following terms:
1. Authors retain copyright and grant the series right of first publication with the work simultaneously licensed under a Creative Commons Attribution License that allows others to share the work with an acknowledgment of the work's authorship and initial publication in this series.
2. Authors are able to enter into separate, additional contractual arrangements for the non-exclusive distribution of the series's published version of the work (e.g., post it to an institutional repository or publish it in a book), with an acknowledgment of its initial publication in this series.
3. Authors are permitted and encouraged to post their work online (e.g., in institutional repositories or on their website) prior to and during the submission process, as it can lead to productive exchanges, as well as earlier and greater citation of published work (See Open access policy for details).

References

[1]. Hall, Andrew Thomas, et al. “Multi-criteria analysis of barriers to building information modeling (BIM) adoption for SMEs in New Zealand construction industry.” Engineering, Construction and Architectural Management 30.9 (2023): 3798-3816.

[2]. Babalola, Ayotunde, et al. “A bibliometric review of advances in building information modeling (BIM) research.” Journal of Engineering, Design and Technology 21.3 (2023): 690-710.

[3]. Biljecki, Filip, Yoong Shin Chow, and Kay Lee. “Quality of crowdsourced geospatial building information: A global assessment of OpenStreetMap attributes.” Building and Environment 237 (2023): 110295.

[4]. Hagedorn, Philipp, et al. “BIM-enabled infrastructure asset management using information containers and semantic web.” Journal of Computing in Civil Engineering 37.1 (2023): 04022041.

[5]. Kuhn T 1998 Density matrix theory of coherent ultrafast dynamics Theory of Transport Properties of Semiconductor Nanostructures (Electronic Materials vol 4) ed E Schöll (London: Chapman and Hall) chapter 6 pp 173–214

[6]. Börzel, Tanja A., et al. “Contesting Europe: Eurosceptic dissent and integration polarization in the European parliament.” JCMS: Journal of Common Market Studies 61.4 (2023): 1100-1118.

[7]. Lowe, Nichola, et al. “Centering work: Integration and diffusion of workforce development within the US manufacturing extension network.” Economic Development Quarterly 37.4 (2023): 375-388.

[8]. Asci, Francesco, et al. “Pain-motor integration in chronic pain: A neurophysiological study.” Clinical Neurophysiology 154 (2023): 107-115.

[9]. Almashhadani, Mohammed, Hasan Ahmed Almashhadani, and H. A. Almashhadani. “The Impact of Education on Construction Management: A Comprehensive Review.” International Journal of Business and Management Invention 12.6 (2023): 284-290.

[10]. Likita, Ayuba Jerry, et al. “Lean and BIM integration benefits construction management practices in New Zealand.” Construction Innovation 24.1 (2024): 106-133.
